Budgeting/Estimating.

The following documents are examples of time, labor, and monetary estimation

that emphasize the value of accurate scheduling.

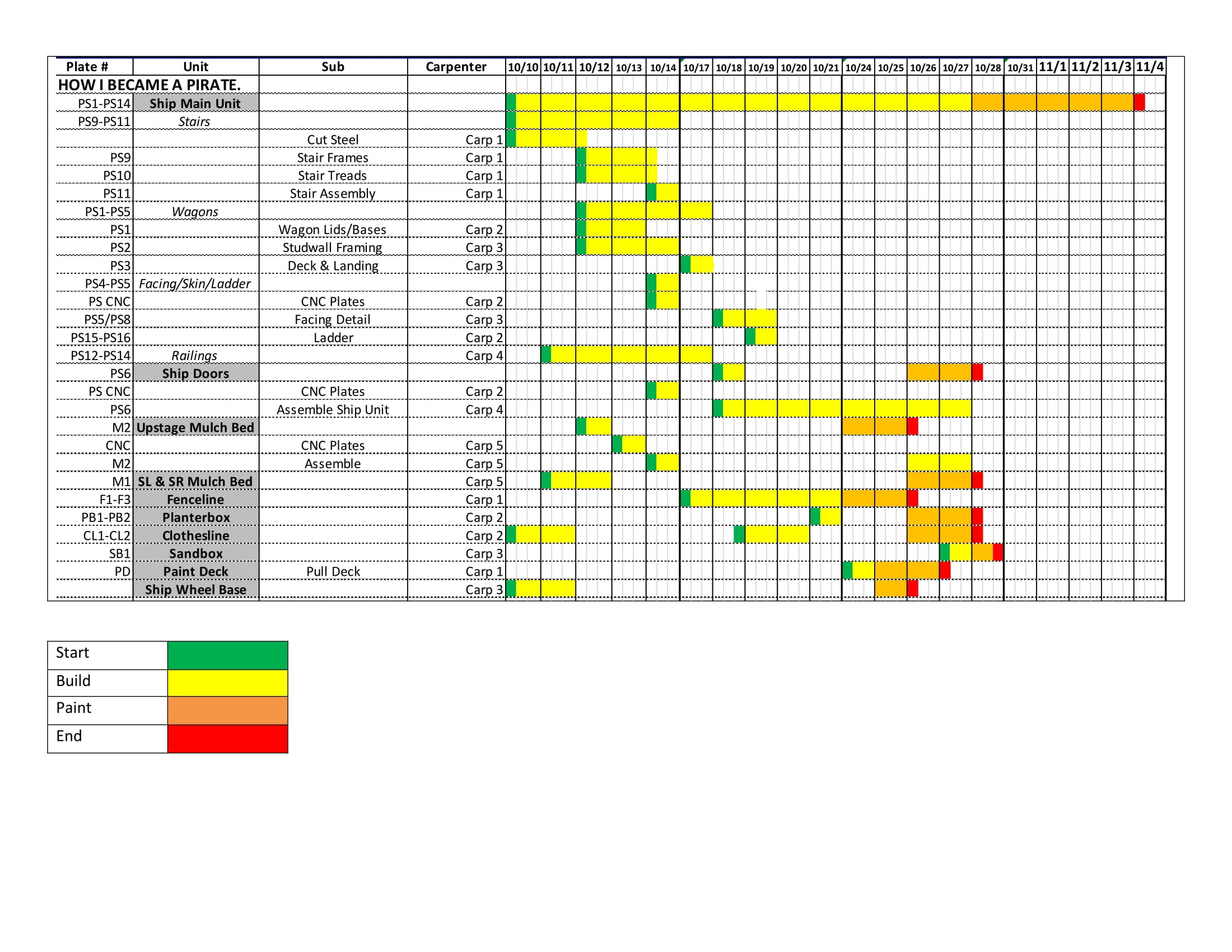

Gantt Pirate-1.jpg

Build/Paint Gantt Chart

The following Gantt chart is an example of how to organize projects by date and carpenter, ensuring efficiency between various departments.

production estimation

This estimation packet is an example of the detailed & itemized documents that are necessary for properly pricing out a show.

Class Gradebook-1.jpg
Rosencrantz Load in plan V2 Final (1)-1.jpg

Class gradebook

The following is a document I created for accurate tracking of grades & classroom attendance.

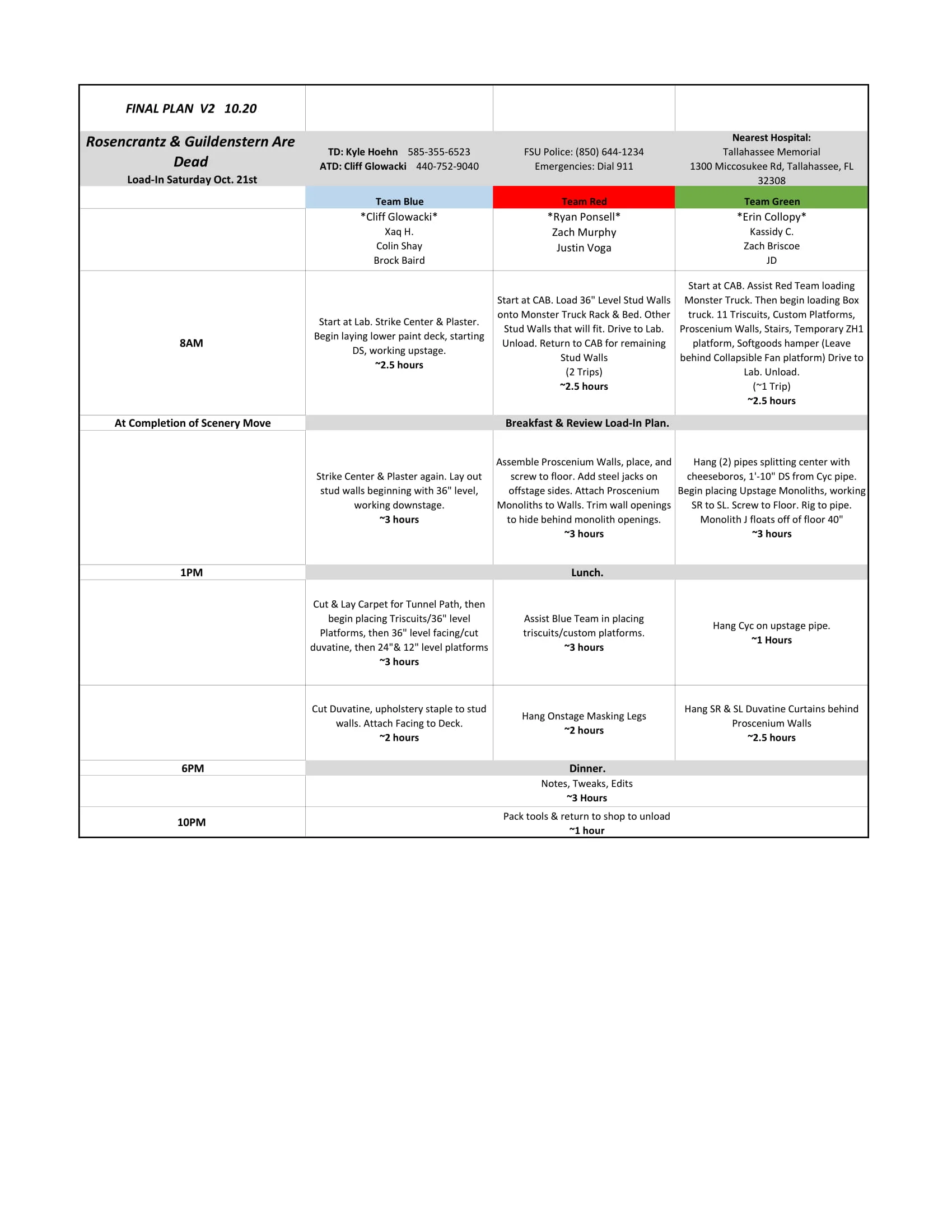

Load-In Plan

An essential schedule for managing a crew.
